2       General Reports

2.1     Current Works

RECORD NUMBER:       2018/1857

AUTHOR:                       Ian Greenham, Director Technical Services





EXECUTIVE Summary

The purpose of this report is to update Council on construction and maintenance works which have been carried out since the last current works report to Council.

Link To Delivery/OPerational Plan

The recommendation in this report relates to the Delivery/Operational Plan strategy “14.1 Our Environment – Design and construct new infrastructure assets as specified with the Asset Management Plan to agreed levels of service”.

Financial Implications

Nil

Policy and Governance Implications

Nil



Recommendation

That the information provided in the report on Current Works be acknowledged.





further considerations

Consideration has been given to the recommendation’s impact on Council’s service delivery; image and reputation; political; environmental; health and safety; employees; stakeholders and project management; and no further implications or risks have been identified.

SUPPORTING INFORMATION

Road Maintenance

Shoulder grading and drainage improvements were undertaken on Council’s rural road network at Whiley Road and Ophir Road.

Kerb and gutter replacement and reshaping of the road shoulder was undertaken on Coronation Drive.  Work was also undertaken to raise and level the pavement around water valves outside the high school.  Asphalt sourced for these projects has not performed well and the supplier has admitted issues with the batching process on the day.  Council officers are currently discussing reparation with the mix supplier and will renew the patch when written agreement is reached.




Road Upgrading

Cargo Road

Works continued on drainage installation on Cargo Road and the intersecting roads of Yackerboon Place, Carwoola Drive and Witton Place. Conflicting Telstra and gas services were adjusted to suit the design grades of the new pipe network.

Forest Road - Bloomfield

Quality issues with the asphalt surfacing have been raised with the subcontractor who supplied and laid the product recently outside the hospital. Representatives from the company have come up from Sydney and verbally advised that they agree that the outcome is not up to an appropriate standard and will propose remediation actions to Council’s head contractor in the near future.

Traffic signal poles have been installed at the intersection of the base hospital.  Commissioning of these signals is dependent on the completion of street lighting upgrading and compliant line marking at the intersection.

Works continued on installing piped drainage at the northern end of the project.

Indications are that the project should reach completion by end of October 2018.

CONCRETE AND DRAINAGE

Maintenance

Grinding of concrete trip hazards was undertaken on Anson Street.

Replacement of tree root damaged asphalt path sections was undertaken in Nile Street.

New Works

Footpath rehabilitation

Footpath rehabilitation projects were completed in Sampson Street from Summer Street to Byng Street and also from Kite Street to Moulder Street.

A new footpath rehabilitation project was started in March Street from Hill Street to Sale Street and a new footpath was laid in March Street from Park Street to Spring Street.

SEWER MAINTENANCE



Category

July 2016 – June 2017

June 2018

Sewer blockages

359

45

Odour

11

1

Overflows

139

8

Total Sewer Requests

509

54

Sewer Construction Works

·        Sewer rising main pressure testing at the Airport

·        138 Diamond Drive - sewer maintenance shaft installation




Sewer Reconstructions

·        19 Woodward Street

·        7 Wattle Avenue

WATER MAINTENANCE




Category

July 2016 – June 2017

June 2018

Leaking meters

496

69

Faulty meters (incorrect readings)

145

11

No supply

52

3

Water pressure complaints

33

3

Meter box/lid replacements

62

5

Water quality

51

0

Service break

11

1

Service leak

47

0

Main break

76

5

Main leak

288

29

Valve leak

12

1

Hydrant leak

59

3

Total Water Requests

1332

130

During the period 15 July to 24 July 2018 Council experienced a substantial increase in the number of Customer Service calls due to frozen water services and water meters as a result of freezing overnight temperatures. Water staff are to be congratulated for their response to these call outs, with emails and feedback received from the general public about the positive attitude and helpfulness of staff when attending these incidents.

New Water Services

·        63 Hill Street - 32mm fire service

·        4 Yarran Place - 20mm service

·        138 Diamond Drive - 20mm dual water service

·        Jack Brabham Park

·        225 McLachlan Street - 32mm water service

·        30 Colliers Avenue - 32mm service

·        16 William Maker - 100mm fire service, 40mm potable and 25mm non potable.

Water Service Renewals

·        51 Hill Street

·        200 Dalton Street

·        13 March Street

·        12 Glenroi Avenue




WATER STORAGE

Water Storage Levels



Location

Date

Level Below Spillway (mm)

% of Capacity

Suma Park Dam

20 July 2018

7,282

49.49%

Spring Creek Dam

20 July 2018

904

80.38%

Lake Canobolas

20 July 2018

1,264

66.53%

Gosling Creek Dam

20 July 2018

1,137

68.72%

Supplementary Raw Water Sources

Extractions from the supplementary raw water supplies in recent months are provided in the table below.



Raw Water Source

Apr 2018 (ML)

May 2018 (ML)

June 2018 (ML)

Total 2017/2018

Bores*

20.61

15.88

12.34

98.59

Stormwater

0.00

4.61

35.78

153.30

Macquarie River

0.00

0.00

0.00

69.04

Total

20.61

20.49

48.12

320.93

* Bores include two at Clifton Grove and one at the Showground

Information on the Decision Support Tool, which is used to determine the need for the transfer of supplementary raw water sources, and a more detailed monthly summary of raw water transfers can be found on Council’s website at
http://www.orange.nsw.gov.au/site/index.cfm?display=604698.




Drinking Water Quality

Water samples are collected as a component of Orange City Council’s Drinking Water Quality Monitoring Program which forms part of the NSW Health requirements. Samples are collected regularly and sent to a NSW Government National Association of Testing Authorities (NATA) accredited laboratory for analysis. Samples collected in June 2018 complied with the Australian Drinking Water Guidelines, 2011.

Water Consumption

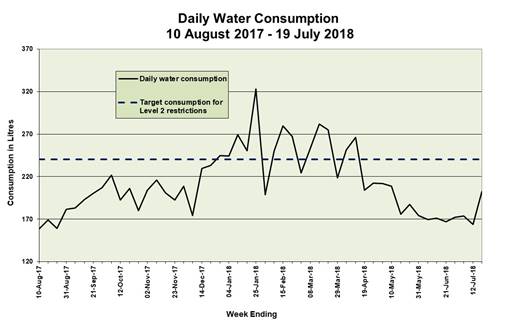

Average daily water consumption during the week ending 19 July 2018 was 202 litres per person per day. This increase (when compared to previous weeks) was due to leaks from broken water services, meters and internal house plumbing over the period 15 July to 24 July 2018 as a result of freezing overnight temperatures.

The average daily city-wide water consumption for the period 25 June 2018 to 25 July 2018 was 13.02ML.

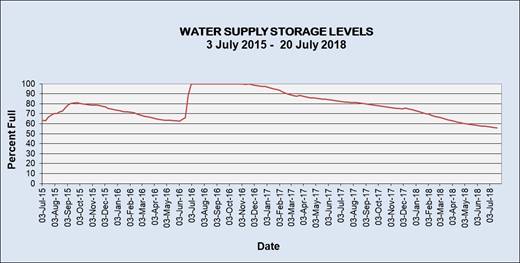

Council is currently on Level 2 water restrictions with a total combined storage level of 55.6%.

CENTRAL TABLELANDS REGIONAL WATER SECURITY PROJECT – Orange To Carcoar Pipeline

The Current date for practical completion of the Orange to Carcoar Pipeline including all commissioning is 30 November 2018.  Works will commence next month in preparation for the valves that are on order to complete the works.

Pure Technologies utilised their “smart ball” technology to acoustically identify leaks along the vandalised effluent line between Orange and Spring Hill.  While the smart ball was sent along the full 10km of pipeline, only data for 2km was analysed where we believed the remaining leaks were to be found.  Two holes were identified and subsequently repaired.  The pipe is now waiting for further pressure testing.  If pressure loss is experienced further analysis of the data will need to occur.

AIRPORT PASSENGER NUMBERS

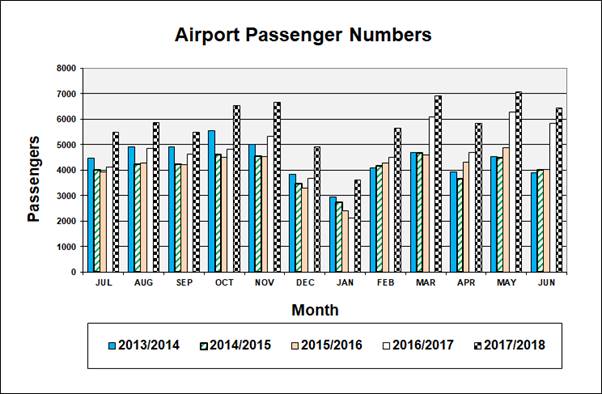

Passenger numbers for June 2018 were 6,437 compared with 5,838 in the same month in 2017.





Airport Energy Usage

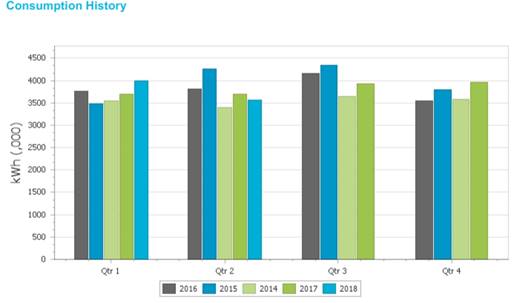

Energy used at the airport during June 2018 was 26,946.52 kWh at a cost to Council of $6,889.86.

ENERGY USE

The following information is sourced from E21, Council’s energy software.

23 July 2018
